November 2025 Update

The Jaycee Park project remains on schedule, and among the work that’s been completed this month:

Wausau benches, playground equipment, and Vortex misters delivered. Restrooms 1 & 2 and Bandshell doors and hardware delivered.
Restrooms 1 & 2 and Bandshell exterior stucco, HVAC ducts, and doors installed. Restroom 1 metal roof installed, Restroom 2 metal roof in process. Restrooms 1 & 2 epoxy flooring in process. Dumpster Enclosures 1 & 2 metal coping installed. Bistro underground completed, prepping for slab pour.
First asphalt lift installed. Sidewalks and curbs in process. All weirs installed and 11/19/25 approved by Jason Sheridan, Pennoni.
Overlook and retention boardwalks decking completed. Pavilions foundations and slabs completed.
LCEC set new South transformer. Splash Pad and playgrounds in process.
Irrigation branch lines in process. Tree planting started on Northside.

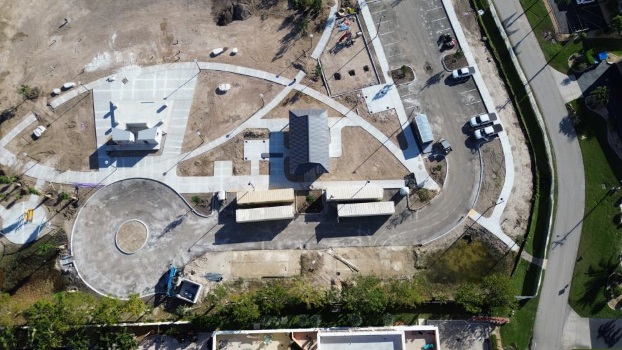

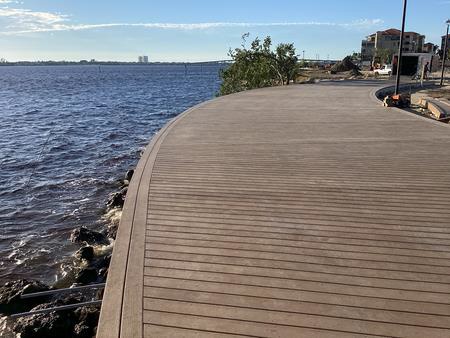

jayceepark-nov2025 jayceepark2-nov2025
October 2025 Update

The Jaycee Park project remains on schedule, and among the work that’s been completed this month:

Restrooms 1 & 2 wood trusses/plywood decking installed, dry-in completed, fascia metal wrap installed, and first coat interior paint completed. Restroom 1 overhead coiling door installed and exterior stucco lath in process. Bandshell remaining slab, ramps, and stairs poured, ceiling framing in process. Bistro stem walls installed/cells filled, columns poured, and stem wall backfill completed. Restrooms 1 & 2 and Bandshell doors and hardware delivered.
North, center, and South driveways aprons and curbs installed. All site light poles installed. Shade sails foundations and frames installed. Electrical main conduits and irrigation mains installed.
Parking lots base installed in anticipation of first lift of asphalt. North sidewalks substantially installed, remaining sidewalks in process. Center weir corrected, South weir awaiting skimmer parts (RFI 65).
Irrigation branch lines in process. Splash Pad underground in process.
Overlook boardwalk framing completed and decking in process.

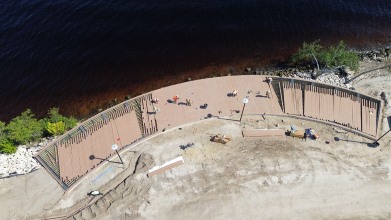

jayceepark-oct2025 jayceepark2-oct2025 jayceepark3-oct2025
September 2025 Update

The Jaycee Park project remains on schedule, with a contractual completion date of April 2026. However, the project manager expects work to finish ahead of schedule early next year. Among the work that’s been completed this month:

99% of the site’s light poles have been set
North and South driveways are in process
Installation of irrigation and electrical conduits is in process throughout the site
Overlook boardwalk framing is in process
“Bistro” building foundation has been poured
Majority of concrete blocks have been filled at Restroom 1, Bandshell and Dumpster Enclosures
Electrical and plumbing wall rough-ins have been completed at Restroom 1 and Bandshell.

August 2025

Site work is continuing at Jaycee Park!

 Dumpster Enclosures 1 & 2 foundations and slabs installed. Cast-in-place benches poured. Bandshell and Restrooms 1 & 2 foundations installed.

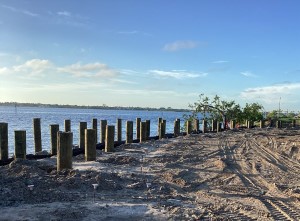

Overlook boardwalk piles installation completed.
Set site light poles, parking lots subgrade and sidewalks installation in process.
North weir installed.
Branch waterlines to Bandshell and Restrooms 1 & 2 installed. Restrooms 1 & 2 underground plumbing rough completed. Bandshell and Restroom 1 & 2 underground electrical rough completed.
Electrical main conduits and irrigation mains in process.

aug2025-piledriving aug2025-overlookpile aug2025-sidewalkinstall

Coming up: We’ll be working on the  weirs, underground plumbing, underground electrical conduits, irrigation, sidewalks, Bistro foundations, Bandshell and Restrooms 1 & 2 slab pours, and laying CMU block walls.

July 2025



Construction is moving forward at Jaycee Park, with progress to share!

 All three grease traps, Center & South weirs, and dry standpipe installation completed.
Northside temporary power panel is energized.
Removal of unsuitable soil at Splash Pad completed.

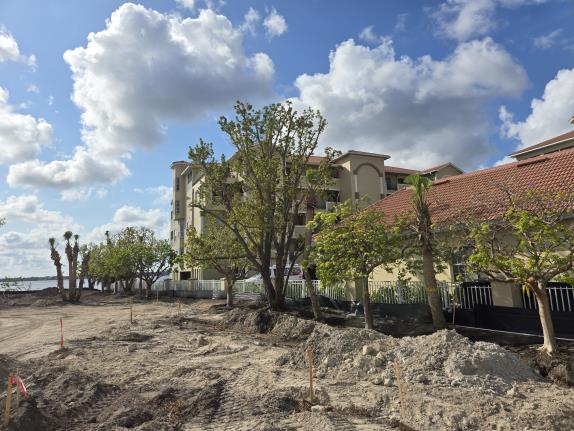

Tree relocation at North and South property lines substantially completed.
Storm structures and storm piping installation completed.
Northside parking lots and ponds rough grade in process.

Coming up:

We’ll be working on the Dumpster enclosure slabs, Irrigation, Underground plumbing, North weir, Electrical conduits, Sewer piping, Irrigation, and Foundations.

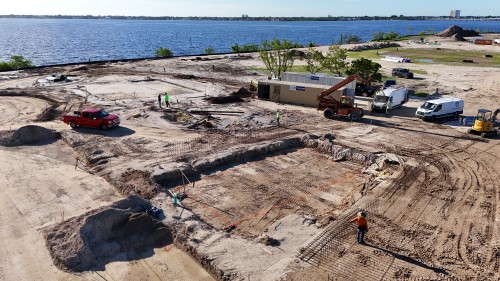

july2025-jayceeupdate2 july2025-jayceeupdate

June 2025
Site work is continuing. Building permits have been issued for the restrooms and bandshell. Concrete pours for the foundations of the structures are expected to begin next week. Optimistic for substantial completion by the end of the year.

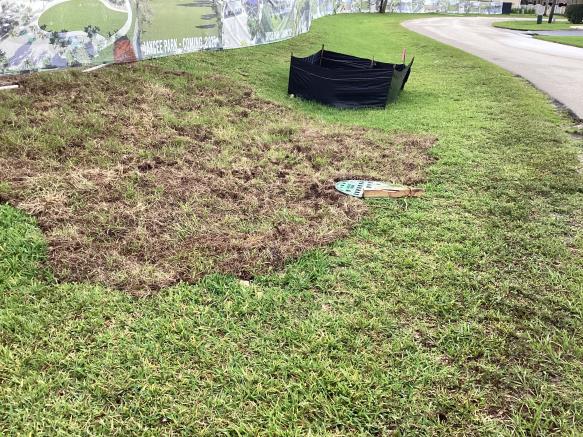

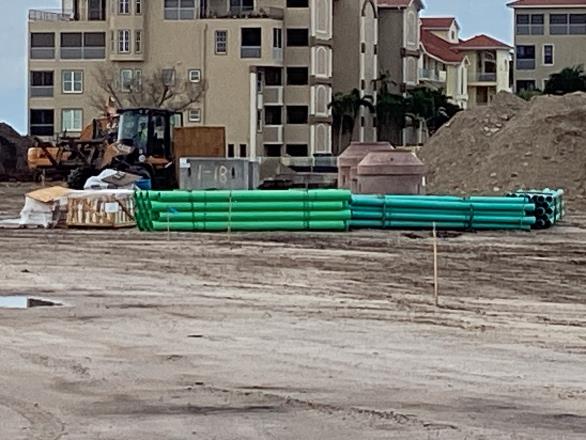

53125-sodreplaced 53125-treelocation 53125-sewerpip

May 2025
Majority of soil renourishment and tree relocation completed. Sewer pipe delivered and sewer connections completed. Storm structures delivered and installed. Storm piping in process.

April 2025: Jaycee Park being leveled and prepared for site improvements. Stabilization and reinforcement work continues along the shoreline. Workers laying stormwater pipe and installing drainage inlets at Jaycee Park.

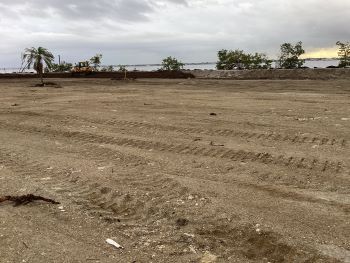

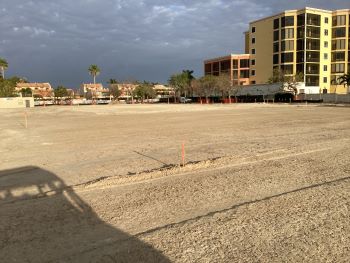

Stabilizing Shoreline Rip Rap 4-8-25 Site Leveling (2) 4-7-25
March 2025:  Clearing, grading, building pad preparation, and fence screens of project renderings installed. Below: Delivery and installation of rip rap.

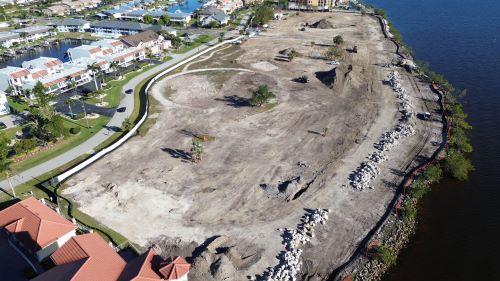

Rip Rap Begins on South End web

February 2025:  Major sitework has begun at Jaycee Park, with the contractor conducting demolition of existing structures (pavilions, playgrounds, restrooms), removal of interior roads and walkways, and tree stump removal. This phase is expected to continue for several months.

While the renovation may cause some temporary inconvenience for nearby residents, the contractor will implement best management practices to minimize impacts. However, noise and dust are unavoidable byproducts of this work. A water truck will be used as needed to control dust, but residents should expect some dust in the area during construction.
